Noise and Vibration Monitoring on Urban Construction Sites: What Every Engineer Needs to Know

Urban construction is loud, complex, and high-stakes. When heavy equipment moves soil, drives piles, or densifies ground just meters from occupied buildings, the energy produced travels through the earth in every direction. Without vibration monitoring, you have no way of knowing how much of that energy is reaching surrounding structures, underground utilities, or sensitive equipment inside nearby facilities.

That is a problem no project team wants to discover after the fact.

Vibration monitoring gives engineers and project managers real-time visibility into ground movement throughout a job. It protects neighboring structures, supports regulatory compliance, and creates a documented record that can defend your team if a damage claim ever surfaces. On urban sites where tolerances are tight and neighbors are close, it is not a nice-to-have. It is a fundamental part of responsible project delivery.

This guide walks through how construction vibration monitoring works, what equipment is involved, and how monitoring integrates directly into ground improvement operations.

Why Vibration Monitoring Matters in Urban Environments

Urban sites do not give you a buffer zone. Roads, utilities, foundations, and occupied buildings often sit within meters of active work. Every hammer blow, every compaction pass, and every piece of heavy equipment sends vibration waves into the surrounding ground. Most of the time, those waves dissipate without incident. But when they reach a vulnerable structure at the wrong frequency or amplitude, the consequences range from cosmetic cracking to serious structural damage.

The Real Risks of Unmonitored Ground Vibration

Ground vibration affects structures differently depending on their age, construction type, and condition. An older masonry building responds very differently to ground movement than a modern reinforced concrete structure. Without a vibration monitoring system in place, you are making assumptions about how your work is affecting everything around you.

The risks of skipping monitoring include:

  • Damage to adjacent foundations, walls, and facades that may not appear immediately
  • Disruption to sensitive equipment inside nearby facilities, including medical devices and manufacturing instruments
  • Settlement or cracking in underground utilities
  • Legal exposure if a neighbor files a damage claim, and you have no data to counter it

With a proper noise and vibration monitoring program in place, your team knows exactly what is happening at every stage of the project.

Regulatory and Contractual Drivers

Most urban jurisdictions have vibration limits tied to either peak particle velocity (PPV) or frequency thresholds. In the United States, the primary technical benchmark is USBM RI8507, developed by the U.S. Bureau of Mines, paired with guidance from the Office of Surface Mining Reclamation and Enforcement (OSMRE). Together, these establish the frequency-dependent PPV limits that most seismograph monitoring equipment is calibrated against, and they’re the standard our field reports reference on every job. Many project specifications also point to guidelines published by organizations like the Federal Highway Administration or set limits directly in the contract documents. In some markets, compliance with standards equivalent to the German DIN 4150 or British BS 7385 is contractually required even outside those jurisdictions, because engineers recognize them as practical technical benchmarks as well.

Beyond regulatory requirements, many project owners now require vibration monitoring data as a standard deliverable. If you are bidding on work in dense urban corridors, expect to see it in the specifications.

How Construction Vibration Monitoring Works

Construction vibration monitoring is not simply placing a device on the ground and watching a screen. An effective monitoring program involves selecting the right equipment, positioning sensors strategically, setting alert thresholds before work begins, and having a clear protocol for what happens when those thresholds are approached or exceeded.

What Gets Measured and Why

The standard measurement in construction vibration monitoring is peak particle velocity, expressed in millimeters per second (mm/s) or inches per second (in/s). PPV captures the maximum speed at which a point on the ground or structure moves in response to a vibration event. It is the most widely used metric because it correlates well with the potential for structural damage.

Beyond PPV, some monitoring programs also track:

  • Frequency content, because low-frequency vibrations travel farther and affect structures differently than high-frequency ones
  • Acceleration and displacement, which are relevant for sensitive equipment and precision manufacturing environments
  • Airborne noise levels, particularly near residential areas, where community impact is a concern

Understanding what you are measuring and why helps you set meaningful thresholds rather than arbitrary ones.

Key Equipment: Sensors, Systems, and Devices

Modern vibration monitoring equipment has advanced significantly. The core of any monitoring setup is a geophone or accelerometer-based sensor that detects ground movement in three axes: vertical, longitudinal, and transverse. These sensors connect to a data logger or vibration monitoring system that records readings continuously or on a triggered basis.

Common configurations include:

  • Standalone vibration monitors are placed at the base of adjacent structures or at set distances from the work area
  • Networked vibration monitoring systems that transmit data in real time to a cloud platform accessible by the project team
  • Wireless vibration monitoring setups that eliminate cabling constraints and make repositioning sensors as simple as work areas shift

For projects involving dynamic compaction or other high-energy ground improvement methods, sensor placement is especially important. Sensors should be positioned between the work area and the nearest sensitive structure, not just at the property line.

Continuous vs. Event-Based Monitoring

Some projects require continuous vibration monitoring throughout construction. Others call for event-based monitoring, where sensors are active only during specific high-energy activities. The right approach depends on the project schedule, the proximity of sensitive structures, and the contractual requirements.

For ground improvement work like deep dynamic compaction, continuous monitoring during active treatment phases is standard practice. You can review our full range of ground improvement capabilities to see how monitoring integrates into each stage of a project.

Building Vibration Monitoring: Protecting Nearby Structures

When work happens adjacent to occupied or historically significant buildings, building vibration monitoring adds another layer of protection. Rather than measuring ground response only, sensors are mounted directly to structural elements such as foundation walls, columns, or floor slabs to capture how the building itself is responding.

Threshold Standards and Alert Levels

Threshold levels are set before work begins based on the structure type, condition, and applicable standards. A typical program establishes three tiers:

  • A green threshold, below which work proceeds without action
  • An amber alert level, which triggers a review of work methods and potentially a reduction in energy input
  • A red limit, which requires an immediate work stoppage and assessment

Setting these levels requires engineering judgment. A well-maintained reinforced concrete building in good condition can tolerate significantly higher PPV levels than a century-old unreinforced masonry structure. Applying the same limit to both without considering their characteristics is neither accurate nor conservative; it is simply uninformed.

How Data Is Used in Real Time

The value of real-time data is that it allows the project team to act before a threshold is exceeded rather than after. When a vibration monitoring system transmits live readings, the equipment operator, site supervisor, and engineer can all see what is happening simultaneously. If readings climb toward an alert level, the team can adjust drop heights, shift work locations, or pause high-energy operations before any threshold is breached.

Post-event, that same data becomes part of the project record. Timestamped vibration logs tied to specific work activities are invaluable documentation if a neighbor later claims construction caused damage to their property.

Ground Vibration Monitoring During Ground Improvement Work

Ground improvement methods, particularly those involving repeated high-energy impacts, generate significant ground vibration. Proper ground vibration monitoring is not optional on these projects. It is a core part of responsible execution.

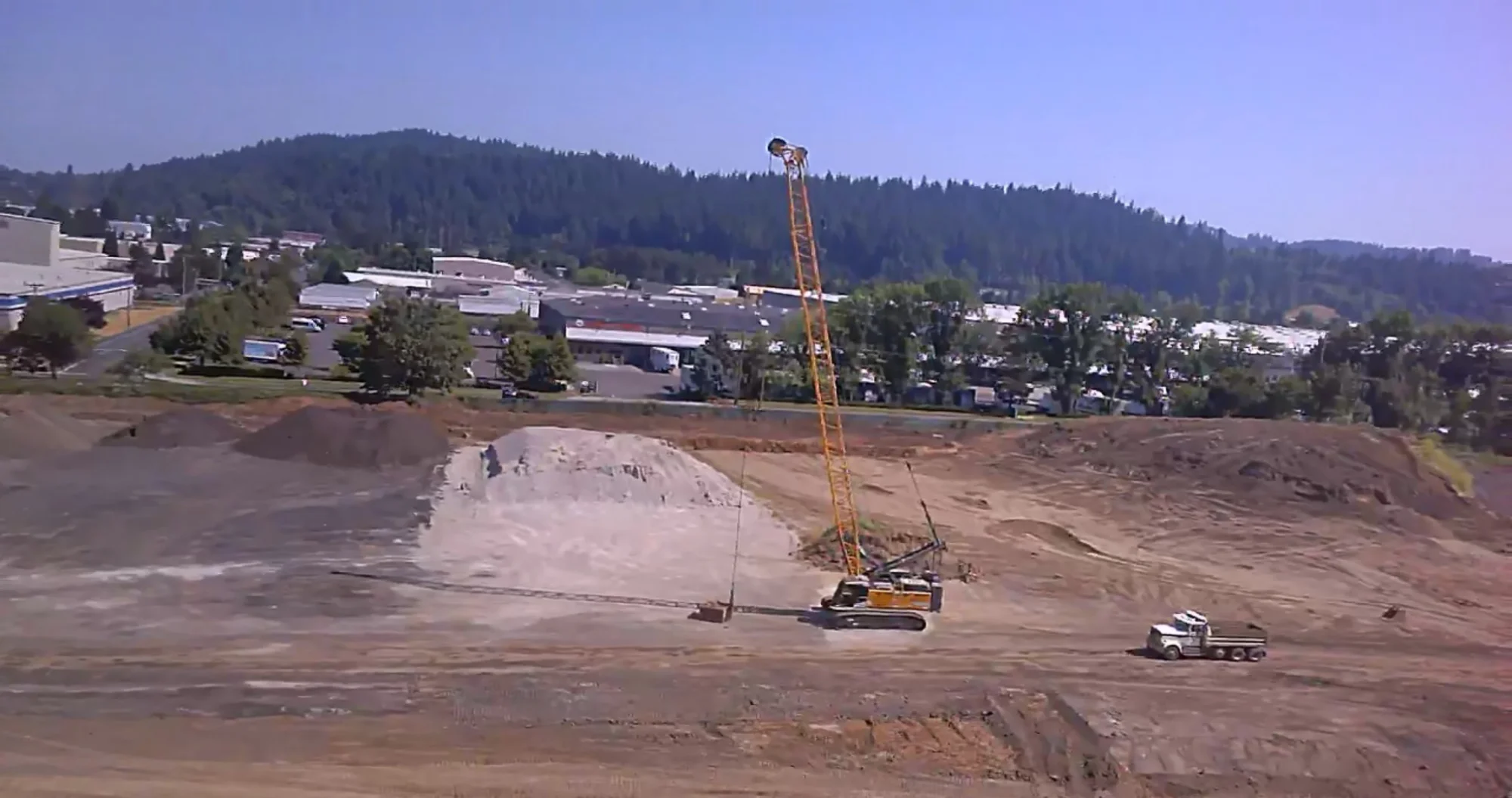

Vibration Produced by Dynamic Compaction

Dynamic compaction involves dropping a heavy weight repeatedly onto the ground surface from a height. Each impact sends a wave of energy into the soil that both densifies it and propagates outward as a ground vibration event. The amplitude of that vibration depends on the weight of the pounder, the drop height, the soil type, and the distance from the impact point.

At Densification, Inc., we treat vibration monitoring as integral to dynamic compaction work, not a separate service layer added on top. Before treatment begins on any project near sensitive structures, we establish monitoring positions, set site-specific thresholds, and confirm that our work program accounts for vibration management from the first drop.

The DFI Journal and related geotechnical publications provide detailed guidance on vibration attenuation relationships for high-energy compaction methods, and our field programs are designed with those reference benchmarks in mind.

How Monitoring Integrates Into the Compaction Workflow

During active compaction phases, vibration data is reviewed after each pass or set of drops. If readings near sensitive structures approach alert levels, the team adjusts the work program. That might mean reducing drop heights, increasing the distance of the nearest impact point from the monitored structure, or changing the sequence of treatment to allow ground response to stabilize between phases.

After treatment is complete, post-improvement testing validates that the work achieved its densification objectives. You can find an overview of our testing and analysis approach in our technical resources.

What to Look for in Vibration Monitoring Services

Not every vibration monitoring program is equal. The quality of the outcome depends on the experience of the team setting it up, the equipment they use, and the rigor of their reporting.

On-Site vs. Remote Monitoring Capabilities

Some projects require a technician on-site throughout active work phases. Others rely on remote monitoring through a networked vibration monitoring system that alerts the project team automatically when thresholds are approached. Both approaches have their place, and the right choice depends on the nature of the work and the sensitivity of the surrounding environment.

For high-energy ground improvement work in dense urban settings, a hybrid approach often works best: automated, real-time alerts via a networked system, supported by periodic on-site reviews by a qualified engineer who can interpret trends and recommend adjustments.

Reporting and Documentation

Vibration monitoring services should include clear, usable reports. At a minimum, look for:

  • Time-stamped event logs tied to specific construction activities
  • PPV readings at each sensor location for every monitoring period
  • Graphical summaries showing readings relative to alert and limit thresholds
  • A written summary interpreting results in the context of the applicable standards

This documentation protects the project owner, the contractor, and the engineer of record. It also creates a baseline for future phases of work on the same site.

When you work with a contractor who integrates vibration monitoring into their ground improvement program from day one, you eliminate the coordination gap that often creates problems on projects where monitoring is treated as a separate subcontract. To learn more about how we approach monitoring in our ground improvement work, contact the Densification team.

Frequently Asked Questions

What is vibration monitoring in construction?

Vibration monitoring in construction is the process of measuring and recording ground and structural vibration caused by construction activities. Sensors placed at strategic locations capture peak particle velocity readings in real time, allowing project teams to confirm that vibration levels stay within safe thresholds for adjacent structures and utilities throughout the project.

What equipment is used for construction vibration monitoring?

Construction vibration monitoring typically uses geophone-based sensors or accelerometers that measure ground movement in three axes. These sensors connect to data loggers or networked vibration monitoring systems that record readings continuously or on a triggered basis. Modern setups are often wireless, making repositioning straightforward as work areas shift across a site.

What is peak particle velocity, and why does it matter?

Peak particle velocity, or PPV, is the standard metric used to quantify ground vibration in construction. It measures the maximum speed at which a point on the ground or structure moves in response to a vibration event. PPV correlates well with potential for structural damage, which is why most vibration limits in construction specifications and regulatory frameworks are expressed in PPV terms.

How close to a building can dynamic compaction work proceed safely?

The safe working distance for dynamic compaction near a building depends on the energy per drop, soil conditions, and the sensitivity of the adjacent structure. There is no universal fixed distance. The right approach is to establish a site-specific vibration monitoring program with pre-set thresholds before work begins, and to adjust the work program in real time based on monitored data.

Do I need continuous vibration monitoring or only during active work?

For most urban ground improvement projects, monitoring should be active during all high-energy work phases. Whether you need continuous 24-hour monitoring or event-based monitoring depends on the project schedule, contractual requirements, and the proximity of sensitive structures. A qualified geotechnical contractor can help you determine the appropriate level of monitoring coverage for your specific site conditions.
